82 San Juan Drive

82 San Juan Drive

Ponte Vedra Beach, FL 32082



Watch this video for details on the PREFER model and the 82 San Juan property.

PREFER Loan Amount

Total Raise: $1,000,000

PREFER Secured Loan Interest: $270,000

Cash on Cash Return: 27%

BECOME A LENDER ON A THIS DEAL

Property Details

  • NEW BUILD

  • 4 Beds, 5 Baths, 4,337 Sq. Ft.

  • Prestigious Old Ponte Vedra

  • Golf Course Views Front & Back

  • 2 Blocks from Ponte Vedra Inn & Club

  • Private Beach Access


Property Data

Buy Price: $2,650,000

  • Construction Cost: $2,200,000

  • Estimated Completion: 10-12 Months

Estimated After Repair Value: $7,500,000+

Estimated to Market: Late 2026 / Early 2027

Estimated Payout: Early 2027

The PREFER Model

  • High-End Luxury Fix & Flips and New Builds

    • Operating only in coastal markets

    • Choosing properties that are not selling for their full value because they’re out of date and missing the key features & amenities luxury buyers are looking for.

  • Totally Passive

  • Short-Term Cash on Cash Returns

    • 10-12 Month Construction Timeline

  • Fractional

    • $50,000 Minimum

  • Geographic Mobility

    • Lender doesn’t have to be local to the property.

  • Extensive Due Diligence

    • Several third-party appraisals and consultations with local real estate agents and professionals to ensure these deals will produce the expected returns.

Property Updates

03.07.26 Update

  • Project underway

  • All permitting and architectural plans complete

01.31.26 Update

  • Project is already underway!

  • All permitting and architectural plans complete

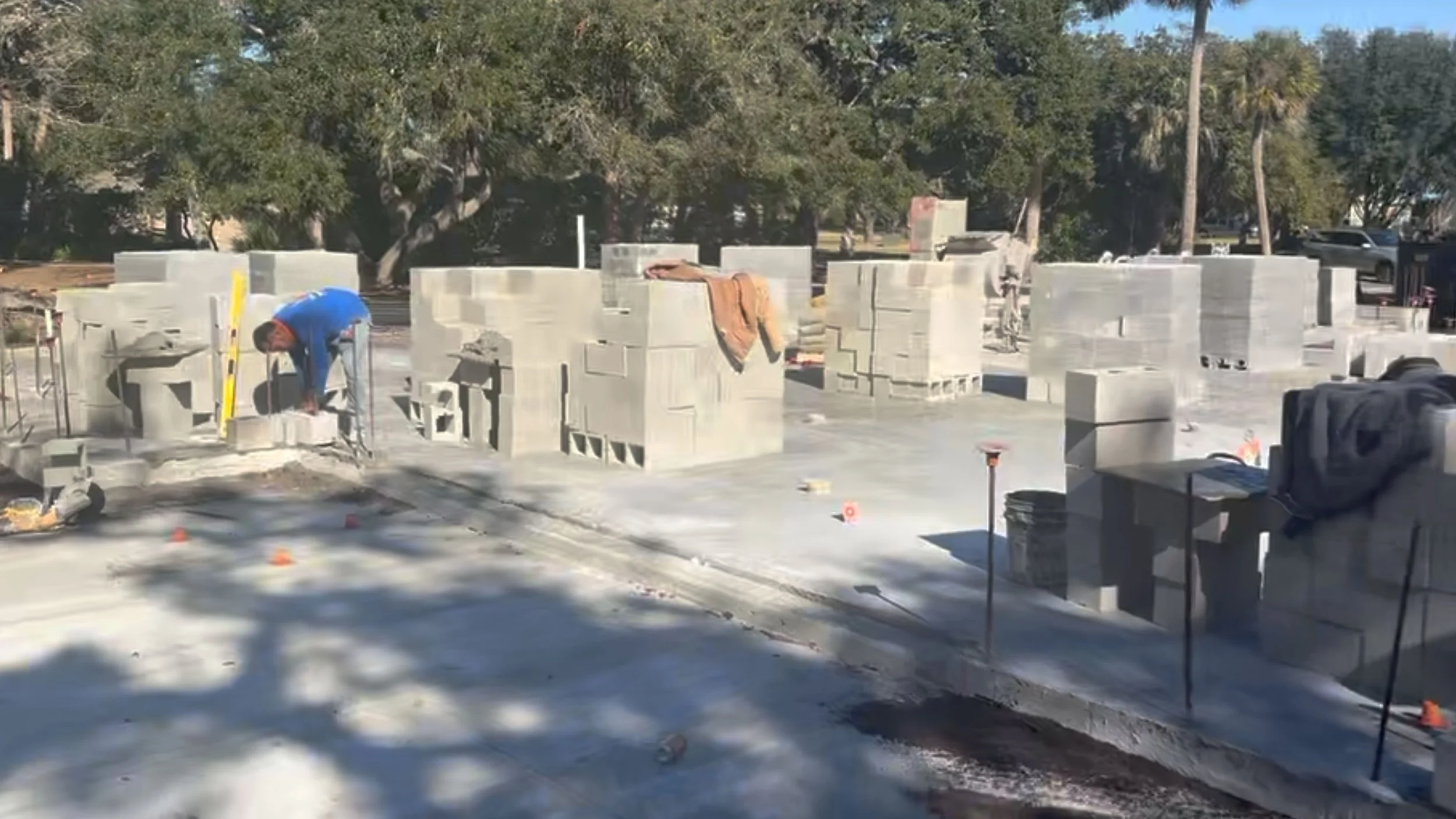

  • Slab laid last week

01.21.26 Update

  • Project is already underway!

  • All permitting and architectural plans complete

  • Slab laid last week

02.14.26 Update

  • Project is already underway!

  • All permitting and architectural plans complete

  • Slab laid last week

03.20.26 Update

  • Framing nearing completion

  • Window installation to begin

04.03.26 Update

  • Framing Complete

    Window Installation Underway

    New Roof Complete

    HVAC underway

    Dry-In Complete

04.18.26 Update

  • Framing Complete

    Window Installation Underway

    New Roof Complete

    HVAC underway 80% complete

    Plumbers have started the rough holddown

    House wrap has been installed

    Dry-In Complete

05.15.26 Update

  • All Framing is complete

    All windows but the transom have been installed

    Roof and decks are complete

    HVAC is complete

    Plumbers have all the water and waste line complete – waiting on valves

    Hold-down complete

    House wrap has been installed

    Electrical started - complete next week

    Gas rough complete

    Both trees on the golf course side have been removed and stumps ground

    Entire property has been cleared and graded

    Insulation has been measured

    Interior door have been ordered

    Sewer was run and hooked up

    Low voltage is complete

    Exterior finishes has been selected

    Waiting on exterior doors to be delivered, then installed

05.01.26 Update

  • All Framing is complete

  • All windows but the transom have been installed

  • Roof and decks are complete

  • HVAC is complete

  • Plumbers have all the water and waste line complete – waiting on valves

  • Hold-down 95%

  • House wrap has been installed

  • Electrical walk is tomorrow and the electricians start Monday

  • Gas rough is scheduled for 5/11/26

  • Both trees on the golf course side have been removed and stumps ground

  • Insulation has been measured

  • Interior door have been ordered

07.11.26 Update

  • All Framing is complete

  • All windows but the transom have been installed

  • Roof and decks are complete

  • HVAC is complete

  • Plumbers have all the water and waste line complete – waiting on valves

  • Hold-down complete and passed inspection

  • House wrap has been installed

  • Electrical Complete

  • Gas rough complete

  • Both trees on the golf course side have been removed and stumps ground

  • Entire property has been cleared and graded

  • Insulation - Lcynene has been installed

  • Batt insulation installed

  • Interior door have been ordered

  • Sewer was run and hooked up

  • Low voltage is complete

  • Exterior finishes has been selected

  • Exterior Doors Installed

  • Stucco Lathe complete

  • Sheetrock almost complete

  • Custom Cabinets have been ordered

06.26.26 Update

  • All Framing is complete

  • All windows but the transom have been installed

  • Roof and decks are complete

  • HVAC is complete

  • Plumbers have all the water and waste line complete – waiting on valves

  • Hold-down complete and passed inspection

  • House wrap has been installed

  • Electrical Complete

  • Gas rough complete

  • Both trees on the golf course side have been removed and stumps ground

  • Entire property has been cleared and graded

  • Insulation - Lcynene has been installed

  • Batt insulation installed

  • Interior door have been ordered

  • Sewer was run and hooked up

  • Low voltage is complete

  • Exterior finishes has been selected

  • Exterior Doors Installed

  • Stucco Lathe complete

  • Sheetrock scheduled for delivery

  • Custom Cabinets have been ordered

7.23.26 Update

  • All Framing is complete

  • All windows but the transom have been installed

  • Roof and decks are complete

  • HVAC is complete

  • Plumbers have all the water and waste line complete – waiting on valves

  • Hold-down complete and passed inspection

  • House wrap has been installed

  • Electrical Complete

  • Gas rough complete

  • Both trees on the golf course side have been removed and stumps ground

  • Entire property has been cleared and graded

  • Insulation - Lcynene has been installed

  • Batt insulation installed

  • Interior door have been ordered will be delivered next week

  • Sewer was run and hooked up

  • Low voltage is complete

  • Exterior finishes has been selected

  • Exterior Doors Installed

  • Stucco Lathe complete

  • Stucco finish coat being applied

  • Sheetrock sanded and ready for prime coat

  • Custom Cabinets have been ordered

  • Tile has been delivered
